I am trying to use the toolkit to pull activities that have missed their start or finish date.
Yes! There are two ways to track this:
1. Using Integrity Checks
You can monitor this through the Integrity Checks using two key metrics:
- Late Tasks Starting
- Late Tasks Finishing
To enable these:
- In the Integrity Checks screen, click Select Metrics on the left-hand side.
- Tick Late Tasks Starting and Late Tasks Finishing to select them.
- Press OK, and the metrics will automatically update based on the project you have open.

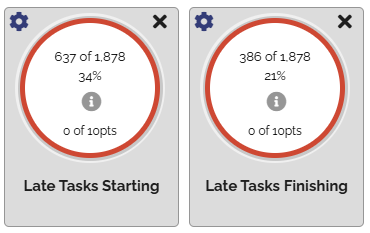

To view the data, simply click on the white circle in each test, and it will
display the relevant details.
2. Using the Dashboard
Alternatively, you can track this through the Dashboard Tool:
- Create a new dashboard item.

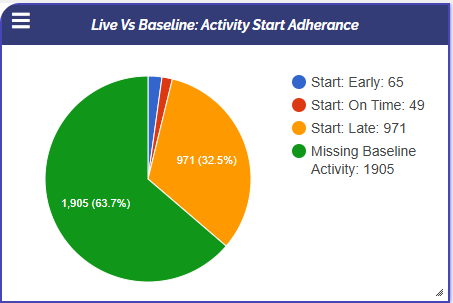

- In the dialog box, select Schedule Adherence as the metric.
- Choose whether you want to track Late Tasks Starting or Late Tasks Finishing.
- To track both, simply add a second dashboard item and select the opposite metric.
Exporting Data from the Dashboard
To extract data for analysis:
- Click on the hamburger menu (☰) at the top left corner of each item.
- Select Export Chart Data to download the relevant information.
This ensures that your dashboard dynamically updates with the latest project data while also allowing you to export and analyse the results as needed.
This is great, but the schedule needs to have a baseline attached , right?
Yes! Here is a video on that…. How to assign a project baseline
